Contractor Termination Letter: A Guide for Tech Leaders

Contractor Termination Letter: A Guide for Tech Leaders

Learn how to write a contractor termination letter with our step-by-step guide for 2026. Covers legal risks, templates, and an enterprise offboarding checklist.

A sprint is slipping. The external ML engineer says the model is “almost there,” but your internal team still can’t reproduce the training run, the handoff docs are thin, and a customer launch date is getting closer. Procurement wants to know whether this is a performance issue or just a scope mismatch. HR is asking for the agreement. Security wants to know when access should be cut.

That’s usually the moment a contractor termination letter becomes urgent. The mistake is treating the letter as the decision. It isn’t. The letter is the record of a decision you should already be able to defend.

For tech leaders, especially those managing AI and data contractors across borders, the work is twofold. You need to end the engagement cleanly, and you need to preserve your company’s position if the contractor disputes the decision later. Generic templates don’t do that well. They’re usually too vague on evidence, too casual on notice, and almost always too US-centric for a distributed workforce.

The Critical Decision Before Writing a Termination Letter

A project manager sees missed milestones and wants a termination letter by end of day. Before anyone drafts it, decide what the company is saying happened. That choice drives notice, payment, cure rights, and the odds of a later dispute.

The first call is whether you are ending the engagement for cause or for convenience.

Distinguish poor fit from breach

A for cause termination says the contractor failed to meet a contractual obligation. That position needs more than frustration with the engagement. It needs a clause, facts tied to that clause, and a record showing the company gave the contractor the process the agreement requires.

A for convenience termination says the company is exercising a contractual exit right without alleging breach. For enterprise teams using international AI and data contractors, that can be the safer path when priorities changed, the project was paused, the work became redundant after a hire, or the statement of work left too much room for interpretation.

If your internal summary is, “this is not working,” pause there. That may support ending the relationship. It does not automatically support a for-cause position.

In AI and data work, scope failure often gets mistaken for performance failure

This issue comes up often with model tuning, data pipeline work, labeling programs, and short-term MLOps support. The contractor may have underperformed. The company may also have given unclear acceptance criteria, inconsistent access to datasets, or changing requirements from product, security, and legal.

Those facts matter. A weakly defined statement of work can make an ordinary project breakdown look like contractor default after the fact.

That is one reason mature teams put contractor oversight rules in place early. Clear review points, acceptance standards, and documentation habits make termination decisions easier to defend later. If your current process is loose, tighten it on the next engagement with these contractor management best practices.

Pressure-test the decision before legal notices go out

Use a simple decision filter.

  • What did the contract require? Check the statement of work, deliverables, milestone dates, acceptance criteria, security obligations, and any documentation or handoff requirements.
  • What facts can you prove? Use dated records such as failed acceptance reviews, missed handoff deadlines, unresolved defects, absent documentation, or written reminders about nonperformance.
  • Was the problem repeated? One bad sprint may justify escalation. Repeated misses after written feedback are far more useful if you are considering cause.
  • Did the company contribute to the miss? Delayed approvals, missing credentials, shifting scope, and unavailable stakeholders weaken a breach argument.
  • What exit path creates the least risk? A convenience termination may cost more in the short term, but it can reduce dispute risk when the cause record is mixed.

For global contractor teams, add one more question. Will the contractor argue local protections, payment rules, or notice standards that your U.S. manager is not thinking about? That risk shows up often with cross-border AI talent sourced quickly through modern platforms, where speed of hiring can hide jurisdictional complexity on the way out.

Build the decision around objective project facts

In software, data, and AI engagements, “poor performance” is too vague to carry much weight on its own. Translate the concern into observable project facts. Examples include missed model delivery dates, failure to document training and evaluation steps, inability to pass code review, broken data lineage, security workarounds, or handoff gaps that leave your internal team unable to operate the system.

I usually tell managers to ask one practical question. Could a neutral reviewer read the file and understand the problem without sitting through your team’s frustration?

If the answer is no, do more work before sending the letter. A structured contract review checklist helps teams line up the contract terms, notice requirements, and remedy options before they commit to a termination theory.

Choose the defensible exit, not the emotionally satisfying one

A weak contractor can slow a launch. A poorly handled termination can create payment disputes, IP friction, access problems, and a claim that the company ignored its own agreement.

For-cause termination is sometimes the right call, especially where there are repeated failures, ignored written notices, confidentiality concerns, or security exposure. But when the record is mixed, convenience is often the cleaner answer. It may feel less forceful. It is often easier to defend.

Your Pre-Termination Legal and Contractual Checklist

A bad termination file usually starts the same way. The manager is done with the contractor, Slack is full of complaints, access problems are piling up, and nobody has checked the notice clause. For AI and data engagements, that gap gets expensive fast because the offboarding risk is not just payment. It is model artifacts, training data access, undocumented pipelines, customer data exposure, and IP that may sit across multiple systems or jurisdictions.

A professional hand with a gold watch holds a pen over a legal checklist on a clipboard.

Read the agreement from the exit clauses backward

Start with the signed contract and every active statement of work. Then read the parts that control how the relationship ends. Project teams often know the performance problem well, but miss the mechanics that turn a justified decision into a contract dispute.

Focus on five areas:

  1. Termination rights
    Confirm whether the company can terminate for convenience, for cause, or both. Check how the agreement defines cause, if it defines it at all.

  2. Notice requirements
    Verify the required method, recipient, address, and timing. If the contract requires formal written notice to a legal notice address, email to a project channel is not enough.

  3. Cure obligations
    If the contractor gets time to fix the issue, follow that process exactly. Count the days carefully and keep proof of delivery.

  4. Payment terms at exit
    Determine what is owed for accepted work, what can be withheld for disputed work, whether approved expenses remain payable, and whether transition support is billable.

  5. IP, confidentiality, data use, and return obligations
    These terms matter more in AI and data work than in ordinary consulting. Confirm who owns code, prompts, model outputs, datasets, annotations, notebooks, credentials, and derivative work product.

A structured contract review checklist helps teams verify notice, cure, payment, and post-termination obligations before anyone sends a letter.

Check what sits outside the main contract

The cleanest legal analysis can still miss the practical problem if key terms live somewhere else. I see this often with enterprise teams using modern talent platforms such as DataTeams, where the contractor relationship may involve a platform agreement, a client terms schedule, a statement of work, a security addendum, and country-specific onboarding documents.

Pull the full set before approval. That includes:

  • statements of work and change orders
  • NDAs and invention assignment terms
  • data processing or security exhibits
  • platform terms that govern payment flow or notice routing
  • local law addenda for international contractors
  • any policy acknowledgments tied to customer data or internal systems

The termination letter usually follows the main agreement, while offboarding obligations often sit in the annexes.

Build an evidence packet that would make sense to a neutral reviewer

Keep the file tight and factual. A bloated record full of opinion makes legal review slower and weakens the company’s position.

Use documents that answer three questions. What was promised. What happened. What notice did the contractor receive.

Include material such as:

  • Delivery records: milestone plans, acceptance criteria, version history, QA results, failed validation runs, rejected pull requests
  • Project communications: emails confirming missed deadlines, written remediation requests, meeting notes that capture agreed fixes
  • Dependency records: proof your team provided required access, data, credentials, approvals, or technical inputs
  • Risk documentation: security incidents, confidentiality concerns, policy violations, customer impact, or audit failures
  • Internal approvals: the legal, finance, security, and business decision trail

For AI contractors, add one more layer. Preserve the record of who accessed datasets, model weights, cloud workspaces, labeling environments, and third-party tools. If the contractor worked across borders, document where systems were hosted and whether any regulated data was involved.

Review restrictive covenants and post-engagement obligations before access changes

Teams often remember the non-compete or non-solicit issue too late, after the contractor has already exported contacts, copied a repository, or left with customer context that was never properly ring-fenced.

Review any surviving restrictions now, along with confidentiality, invention assignment, and data deletion obligations. The limits of those clauses vary by jurisdiction and contractor classification, so legal should confirm what is enforceable before anyone threatens a remedy. This guide to independent contractor non-compete terms is a useful reference point for that review.

Get the right reviewers involved before notice goes out

This does not require a large meeting. It requires the few people who can confirm the company’s legal position and operational readiness.

FunctionWhat they should confirm before notice
LegalTermination basis, notice compliance, cure history, survival clauses, dispute risk
Finance or APFinal invoice status, approved expenses, offsets, and payment release timing
SecurityAccess map, credential revocation plan, logging preservation, device or key recovery
Engineering or Data leadDeliverable status, repository ownership, handoff gaps, documentation completeness
Procurement or platform ownerWhether a staffing or talent platform has separate notice or closeout steps
HR or People opsRecords retention, communication control, and internal escalation path

One final check matters. Make sure the company can operate the system after the contractor leaves. For international AI and data contractors, the legal basis for termination is only half the job. The other half is knowing where the code, models, datasets, credentials, and know-how are located.

Drafting a Defensible Contractor Termination Letter

A good contractor termination letter is clear, spare, and specific. It should read like a business record, not an argument. The purpose is to communicate the decision, preserve the company’s position, and tell the contractor exactly what happens next.

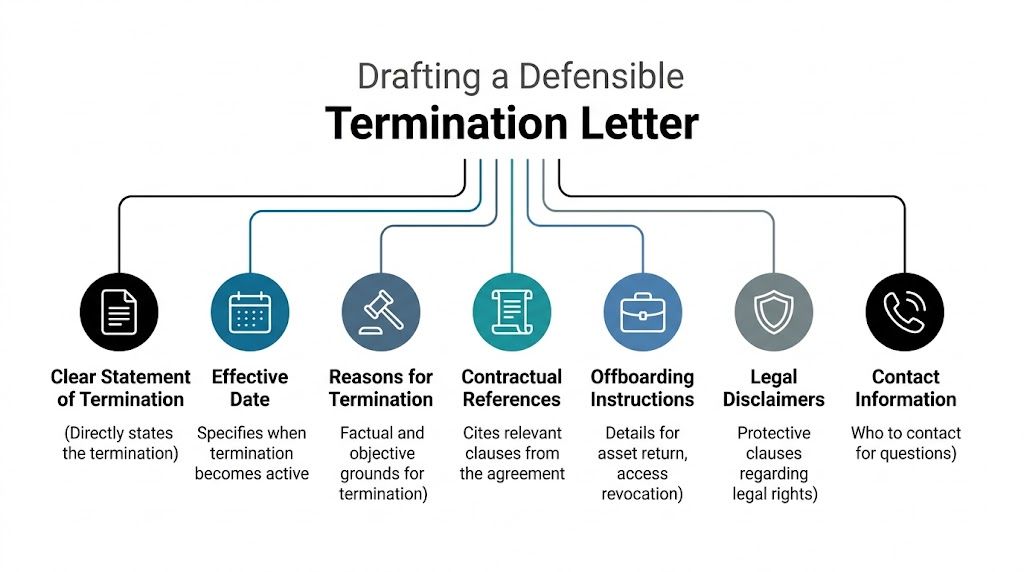

An infographic showing seven key elements for drafting a professional and defensible contractor termination letter.

Protocols that improve defensibility include stating the purpose unequivocally, giving objective grounds, and itemizing financial closeout terms. The guidance collected in these termination letter protocols says such structure can reduce dispute rates by 65%, while vague reasoning is a trigger in 35% of disputes and structured letters yield 75% clean exits.

Start with the parts that identify the record

The opening should make it easy for any reviewer to identify the agreement and the action being taken. Include:

  • contractor legal name
  • address and email used for notice
  • date of letter
  • contract title or statement of work reference
  • contract number or purchase order number, if one exists

Avoid casual subject lines like “Offboarding update” or “Next steps.” Be direct.

Re line: Termination of Independent Contractor Agreement dated [date]

That one line does a lot of work. It tells the recipient and anyone reading later what this document is.

State the decision early and without hedging

The most common drafting mistake is ambiguity. Teams write as if they’re still discussing the issue. If the decision has been made, say so.

This letter serves as formal notice that the Company is terminating the Independent Contractor Agreement dated [date], effective [effective date].

If it’s a for-cause termination, tie it to the clause.

This termination is being made pursuant to Section [X] of the Agreement.

If it’s for convenience, say that instead. Don’t mix the two theories unless counsel has advised you to preserve multiple grounds.

Describe the reasons with facts, not adjectives

The letter should not say the contractor was “unprofessional,” “difficult,” or “not a fit.” Those phrases create heat and add no legal value.

Use objective statements linked to the contract:

The grounds for termination are as follows:

  1. Milestone 3, due on [date], was not delivered.
  2. The Company provided written notice of this issue on [date] and [date].
  3. As of [date], the required remediation identified in those notices has not been completed.
  4. These failures constitute a breach of Sections [X], [Y], and [Z] of the Agreement.

If there was a cure period, reference it. If there were exhibits, identify them, but don’t overload the body with attachments unless you need them.

A useful drafting rule is this: every factual sentence in the letter should be something you could back up with a dated record.

Cover payment, property, and IP in operational language

The financial section should answer basic questions cleanly. What will be paid, when, and under what conditions?

  • Final invoice process: State whether the contractor must submit a final invoice and by when.
  • Accepted work only: If payment is limited to accepted deliverables, say so.
  • Expense status: Address reimbursable expenses if applicable.
  • Setoff or deductions: Include them only if the contract clearly allows them and legal has approved the wording.

Example language:

The Company will process payment for approved and undisputed services performed through the effective date of termination in accordance with the Agreement. Any final invoice must be submitted by [date].

Then deal with assets and information.

By [date and time], please return or confirm deletion of all Company confidential information, credentials, datasets, documentation, and equipment in your possession or control.

For tech contractors, expand this beyond laptops. Mention GitHub, GitLab, Bitbucket, Jira, Confluence, Slack, cloud consoles, model artifacts, notebooks, API keys, shared drives, and client data. If source code or training data is involved, name the repositories or storage environments.

Document systems can help teams keep forms consistent. If your operations team standardizes contractor paperwork through tools for legal documents, use that consistency to ensure your notices, acknowledgments, and return certifications align.

End professionally, not softly

You don’t need warmth if the situation is severe. You do need professionalism. Keep the close short and practical.

Please direct any questions regarding this notice, final payment, or return obligations to [name, title, email].

The Company reserves all rights and remedies available under the Agreement and applicable law.

That reservation sentence is often worth including, especially in a for-cause notice.

What usually makes these letters worse

A few habits create unnecessary problems:

What not to doWhy it creates risk
Threaten legal action in the first paragraphIt escalates the exchange and rarely improves compliance
Add every grievance you rememberIrrelevant complaints weaken the core breach case
Use emotional languageIt makes the letter look retaliatory or careless
Promise things not in the contractInformal concessions create new disputes
Send the wrong version by email onlyNotice defects are avoidable and expensive

The best contractor termination letter often feels almost plain. That’s usually a sign it’s doing its job.

Managing Terminations for a Global Contractor Workforce

The international version of this problem is where generic templates break down first.

A computer monitor displaying a global workforce map on a wooden desk with a glass of ice.

A US manager may assume a contractor relationship can be ended with simple written notice because the agreement says so. That assumption gets risky once the contractor sits in another jurisdiction, works through a local intermediary, or has worked in a way that starts to resemble employment.

The scale of the issue is no longer niche. 70% of companies use cross-border contractors, and a 2024 survey found 42% of firms faced international termination claims due to improper notices, often because templates ignored local notice requirements such as 30 to 90 days in parts of the EU. That finding appears in this discussion of international termination compliance gaps.

Where US-centric letters fail

Most problems fall into a few categories:

  • Notice mismatch: The contract says one thing, local practice or law expects more.
  • Misclassification exposure: The contractor worked under employee-like control, schedule, or exclusivity.
  • Entity mismatch: The company that signed the agreement isn’t the one managing day-to-day work.
  • Post-termination obligations: Local tax, social contribution, or statutory process issues remain even after notice is sent.

That’s why global offboarding has to be coordinated, not improvised. Teams managing a distributed external workforce usually need a more formal governance model than domestic-only teams. This overview of contingent workforce management is useful because it treats contractor administration as an operating system, not just a sourcing decision.

Practical review points by jurisdiction

Don’t try to solve cross-border terminations with a single global template. Use a central structure, then localize the details.

Ask these questions before notice goes out:

  • Is there a local law issue even if the contract chooses Delaware or another US state law?
  • Has the contractor worked only for you, on your schedule, using your equipment or manager approvals?
  • Was an Employer of Record, agent, or local partner involved?
  • Does the jurisdiction expect a minimum notice period, a specific delivery method, or local-language communication?
  • Are there local rules affecting final pay, tax documents, or IP assignment wording?

A short explainer can help internal stakeholders see why these issues matter in practice:

What works in practice

For international AI and data contractors, the cleanest process is usually:

  1. confirm who legally engaged the contractor
  2. have local counsel or a qualified partner review the planned notice
  3. align timing for system access, payment, and equipment recovery
  4. document jurisdiction, governing law, and local compliance steps in the file

A termination letter can be contractually correct and still operationally wrong if local offboarding steps don’t match it.

That’s the hidden challenge of global talent platforms. Speed of hiring is valuable. Speed of termination without local review is where companies create avoidable claims.

A Step-by-Step Offboarding and Asset Recovery Plan

Once the contractor termination letter is sent, the legal question quickly becomes an operational one. Can you close access, recover assets, secure work product, and complete payment without creating new risk?

A silver laptop and an ID badge on a wooden desk represent a corporate offboarding plan process.

A useful model comes from federal procurement. FAR Subpart 49.6 requires precise termination notices and record preservation around key dates. The same source notes that adopting FAR-inspired protocols, including exact timing for access revocation and payment deadlines, can reduce litigation risk by up to 40% in the private sector in the FAR Subpart 49.6 framework.

Run the exit as a timed workflow

Don’t leave offboarding to a string of DMs between managers. Use a same-day checklist with owners and timestamps.

Time windowActionOwner
Before notice is sentConfirm repositories, devices, admin access, and outstanding invoicesManager, IT, Finance
At notice deliveryRecord delivery time and recipient confirmationLegal or People ops
Effective termination timeRevoke access to email, code repos, cloud tools, VPN, and shared drivesIT and Security
Same dayFreeze or archive project spaces for evidence and handoffEngineering or Data lead
Within the stated deadlineCollect equipment, credentials, and written deletion or return confirmationsIT, Ops
After closeoutStore records, final payment proof, and acknowledgment trailLegal, Finance

Focus on tech-specific recovery points

For AI and data contractors, the core risks are rarely just a laptop and badge. They’re usually intangible assets.

Prioritize these items:

  • Repository control: GitHub, GitLab, Bitbucket, package registries, and deployment hooks
  • Cloud environments: AWS, Azure, GCP, service accounts, storage buckets, notebooks
  • Model and data assets: Trained models, prompts, embeddings, evaluation sets, feature stores, ETL jobs
  • Knowledge transfer: Runbooks, architecture notes, MLOps settings, dashboard logic, credential maps
  • Communication tools: Slack, Teams, Jira, Confluence, Notion, Figma, client channels

If you haven’t identified where the contractor stored work product, you’re not ready to terminate them cleanly.

That point is especially important where contractors used personal devices. Require written confirmation that company materials have been returned or deleted, if the contract permits that requirement.

Close out payment with the same precision

Finance should not be guessing what to do after access has been cut. The termination record should already state whether the contractor can submit a final invoice, what counts as accepted work, and where disputes go.

Use exact dates and times where possible. FAR-style precision is helpful here because it reduces ambiguity. If access ends at a specific time, say so. If final invoice materials are due by a specific date, say that too.

Preserve the record after the exit

Store the final package in one place:

  • signed agreement and amendments
  • notices and delivery confirmations
  • evidence supporting the decision
  • payment records
  • return or deletion certifications
  • internal approvals
  • list of systems disabled and when

That archive matters if there’s a later invoice dispute, IP ownership challenge, or confidentiality issue. It also turns a one-off termination into a repeatable process your team can run better next time.

Frequently Asked Questions About Contractor Termination

What if the contractor disputes the termination or refuses to sign anything?

That doesn’t usually block the termination. Most contractor terminations don’t require the contractor’s signature to be effective if you’ve followed the agreement’s notice clause. What matters is that you can prove delivery, preserve the file, and avoid improvising new promises during the dispute.

Should I give a reason if I’m terminating for convenience?

Usually yes, but keep it short and consistent with the contract. You don’t need to manufacture a performance case if the agreement already allows convenience termination. A concise business explanation is often better than silence, as long as it doesn’t contradict the stated contractual basis.

How is terminating a contractor different from terminating an employee?

The legal framework is different, but managers often blur the line operationally. With contractors, the key documents are the services agreement, statement of work, IP terms, and notice provisions. With employees, statutory labor rules usually play a much larger role. The danger in contractor relationships is acting as if they are employees during the engagement, then trying to rely on contractor language only at termination.

Can I terminate by email?

Sometimes, yes, if the contract allows it or if applicable rules recognize electronic notice. But don’t assume. Follow the agreement exactly. If the notice clause requires a particular email address, hard-copy delivery, or another method, use it. The best contractor termination letter loses value fast if it was sent the wrong way.

A clean termination isn’t about having the sharpest letter. It’s about having a coherent reason, a disciplined record, and an offboarding process that protects code, data, IP, and company credibility.


If you're hiring or replacing specialized data and AI contractors, DataTeams helps companies move quickly without sacrificing rigor. Their platform connects teams with pre-vetted data and AI talent across contract, contract-to-hire, and permanent roles, which is especially useful when a project needs continuity after a difficult offboarding.

Blog

DataTeams Blog

Contractor Termination Letter: A Guide for Tech Leaders
Category

Contractor Termination Letter: A Guide for Tech Leaders

Learn how to write a contractor termination letter with our step-by-step guide for 2026. Covers legal risks, templates, and an enterprise offboarding checklist.
Full name
April 17, 2026
•
5 min read
Staffing and Recruiting: How to Hire Top AI & Data Talent
Category

Staffing and Recruiting: How to Hire Top AI & Data Talent

Master staffing and recruiting for data & AI roles. This guide covers how to define needs, source, screen, interview, and retain top 1% professionals.
Full name
April 16, 2026
•
5 min read
A Guide to Hire Machine Learning Experts in 2026
Category

A Guide to Hire Machine Learning Experts in 2026

Our complete guide to hire machine learning experts in 2026. Learn to define roles, source top talent, vet skills, and secure the top 1% of ML professionals.
Full name
April 15, 2026
•
5 min read

Speak with DataTeams today!

We can help you find top talent for your AI/ML needs

Get Started
Hire top pre-vetted Data and AI talent.
eMail- connect@datateams.ai
Phone : +91-9742006911
Subscribe
By subscribing you agree to with our Privacy Policy and provide consent to receive updates from our company.
Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.
Column One
Link OneLink TwoLink ThreeLink FourLink Five
Menu
DataTeams HomeAbout UsHow we WorkFAQsBlogJob BoardGet Started
Follow us
X
LinkedIn
Instagram
© 2024 DataTeams. All rights reserved.
Privacy PolicyTerms of ServiceCookies Settings
